Truck Scale Cost in California (2026): Price Ranges, Hidden Costs and How to Get an Accurate Quote

Crane lowering a steel truck scale weighbridge onto a concrete foundation, illustrating truck scale cost in California for 2026

Quick answer: Published industry guides put a new truck scale at roughly $50,000 to $100,000, and a full turnkey project with a new concrete foundation at about $95,000 to $125,000. Replacing a scale on an existing foundation has been quoted around $80,000. Most of those figures were published in 2022–2023, before U.S. steel prices jumped under the 2025 tariffs, so expect 2026 California quotes to come in higher. Budget too for county registration, calibration and maintenance, which run every year.

Ask ten scale companies about truck scale cost in California and you’ll get ten different numbers. That isn’t because anyone is hiding the price. It’s because a “truck scale” is really a project: the scale, a foundation, electronics, freight, a crane, installation, certification, and years of upkeep afterwards.

Most price guides online give you one headline number and stop there. Many were written years ago, before the steel tariffs of 2025 pushed U.S. steel prices to their highest level since 2023. And almost none mention the California-specific costs that show up after the scale is in the ground.

We’ve installed, replaced and serviced truck scales across California and Arizona for more than 50 years. This guide pulls together the published price ranges, shows where they come from and how old they are, explains what moves the price up or down, and tells you exactly what to have ready so your quote is accurate the first time.

Key Takeaways

  • Published ranges: $50,000–$100,000 for a new truck scale; $95,000–$125,000 for a turnkey project with foundation; about $80,000 to replace a scale on an existing foundation.
  • Those ranges date from 2022–2023. U.S. steel prices were about 70% higher in June 2026 than in February 2025, so newer quotes are likely higher.
  • The foundation is usually the largest site cost. Reusing a sound foundation saves the most money.
  • In California, add county device registration (up to $250 per scale plus up to $120 per location each year) and a weighmaster license if you sell by weight.
  • Yearly maintenance and calibration have been quoted at $1,000 to $10,000, depending on the service plan.
  • Renting, axle scales or a portable scale can be cheaper for seasonal or short-term needs.

2026 Truck Scale Price Ranges at a Glance

These are the most widely published price ranges for U.S. truck scale projects, with their sources and publication dates. Treat them as a starting point, not a quote.

ItemPublished rangeSource and date
New truck scale, headline range$50,000–$100,000Industry price guide, Jul 2022
Basic installation (scale only, foundation separate)$55,000–$80,000Industry price guide, Jul 2022
Turnkey installation (with foundation)$95,000–$125,000Industry price guide, Jul 2022
Truck scale equipment alone$45,000 (basic analog) to $80,000 (heavy-capacity)Industry turnkey project guide, Jan 2022
Concrete foundation (above-ground, with ramps)About $30,000Industry turnkey project guide, Jan 2022
Installation labor and calibration$4,000–$7,500Industry turnkey project guide, Jan 2022
Crane$2,500–$3,500Industry turnkey project guide, Jan 2022
Freight$2,500–$4,500Industry price guide, 2022
Concrete ramps$10,000+Industry price guide, Jul 2022
Replacement on existing foundationAbout $80,000Industry turnkey project guide, Jan 2022
In-ground scale, installed$30,000–$100,000Industry cost guide, 2023 (updated 2025)
Portable axle scales$1,500–$5,000Industry cost guide, 2023

The baseline in these guides is a 70 ft × 11 ft steel-deck electronic scale. Longer, wider, concrete-deck or higher-capacity scales cost more.

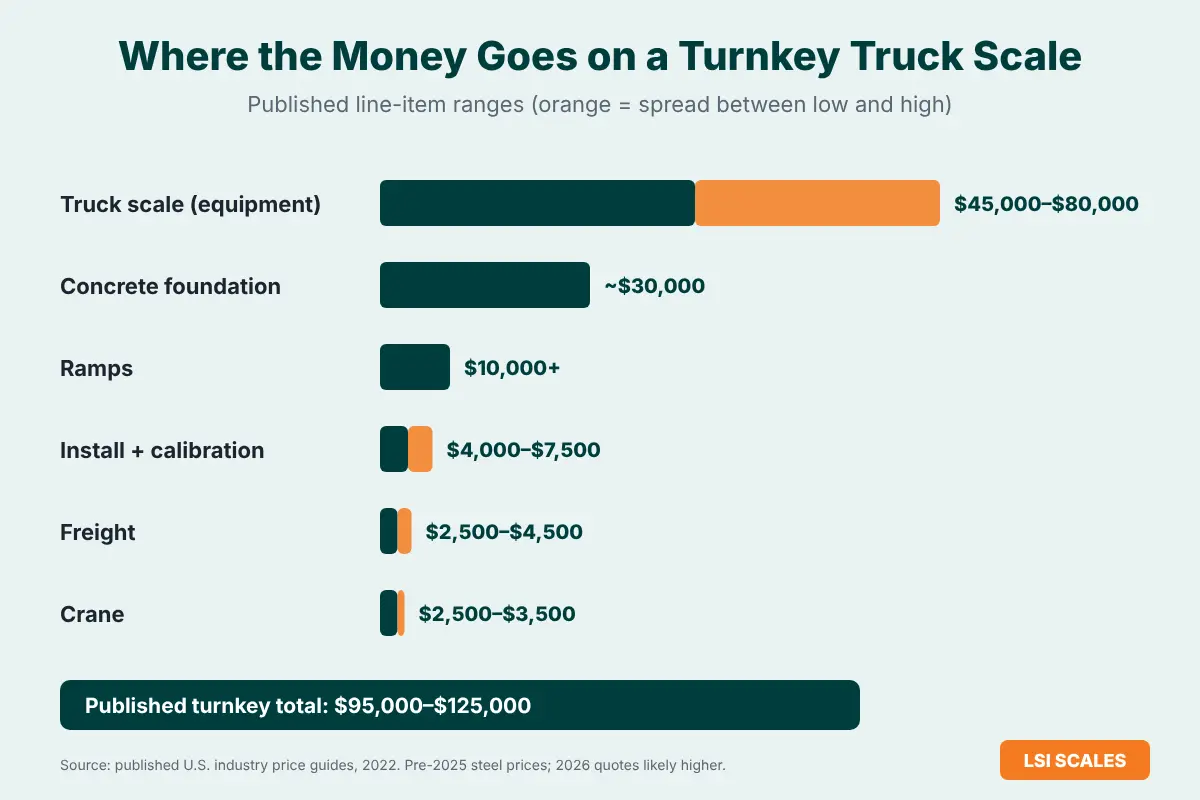

Chart of turnkey truck scale cost by line item: scale equipment, concrete foundation, ramps, installation, freight and crane
Published line-item ranges from industry price guides (2022).

Why Older Price Guides Undershoot in 2026

A truck scale is mostly steel: the weighbridge beams, the deck plate, and often the rebar in its foundation. That makes steel prices one of the biggest swing factors in what you’ll pay.

Steel got much more expensive in the last two years. The Cato Institute reported in July 2026 that U.S. hot-rolled steel hit $1,208 per metric ton on June 24, 2026, the highest reading since April 2023 and about 70% higher than on February 10, 2025, when Section 232 steel tariffs were extended to all countries. Steel imports now carry a 50% Section 232 tariff (Cato Institute).

That doesn’t mean a truck scale costs 70% more; steel is only part of the price. Manufacturers were already adding steel surcharges of 5% to 15% back in 2021, according to published industry guides. When you compare a 2026 quote to a guide written in 2022, expect a gap.

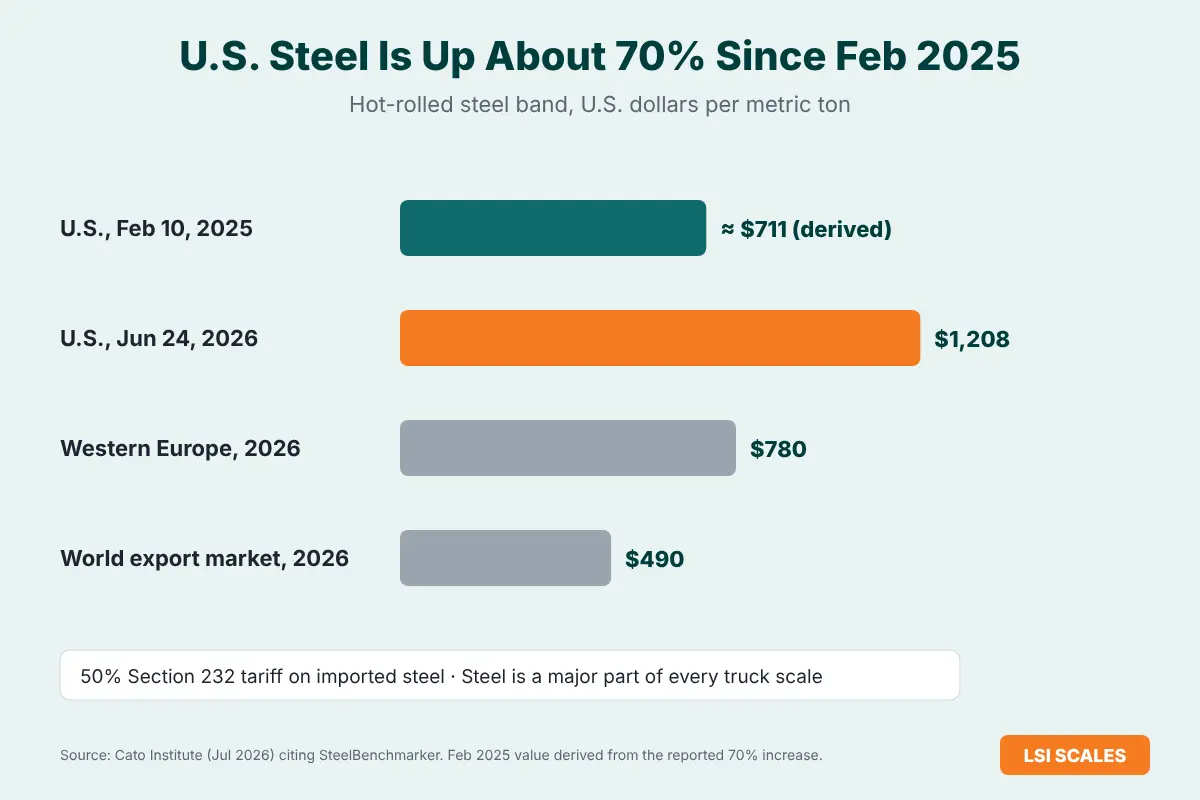

Bar chart showing U.S. hot-rolled steel prices up about 70% from February 2025 to June 2026 under 50% Section 232 steel tariffs
Steel prices are a major reason 2026 quotes run higher.

What Drives the Price of the Scale Itself

Steel Deck vs Concrete Deck

Steel decks ship ready to install and are usually the lower upfront cost. Concrete decks use a steel frame filled with concrete on site, which adds work but gives a heavy, durable driving surface that many high-traffic sites prefer. Ask for both prices if your site could use either.

Length and Capacity

The scale has to be at least as long as the longest vehicle you need to weigh in one pass. The 70 ft scale is the common baseline; 80 ft and longer scales cost more in steel, freight and foundation. Capacity and concentrated load capacity (CLC) matter too, especially if you weigh heavy equipment haulers or electric trucks with heavier axles; see our guide to electric truck weight limits.

Weighbridge Design and Steel Content

Rice Lake points out that weighbridge designs vary: wide-flange I-beam designs usually use more steel than orthotropic, bent-plate or tubing designs, and closely spaced beams add stiffness. It suggests comparing scales by cost per pound of shipping weight, not just the sticker price (Rice Lake).

Analog vs Digital Load Cells

Published guides price a basic analog scale at the low end and heavy-capacity models at the high end. Digital load cells usually cost more upfront but make diagnostics faster, which can cut repair time later. Ask your installer what fits your traffic.

Add-Ons

Remote displays, ticket printers, kiosks, RFID and cameras all add to the price. If you’re thinking about running the scale without an operator, read our guide to unattended truck scale systems before you buy.

Site and Installation Costs

The scale is only part of the bill. On a new site, the work around it can cost almost as much.

Foundation: Pit vs Pitless

Published industry figures put a typical above-ground (pitless) foundation with ramps and approaches at about $30,000, and calls the foundation the main cost driver on new projects. Pit foundations put the deck flush with the ground, which saves space and ramps, but they need deeper excavation, drainage and regular cleaning, so they usually cost more to build and maintain. Soil, drainage and site slope decide which works; in parts of the Central Valley a high water table can rule out a pit.

Excavation, Concrete, Crane and Freight

  • Crane: $2,500–$3,500 to set the weighbridge, including removal of an old steel deck on replacements.
  • Freight: $2,500–$4,500 depending on distance from the factory.
  • Installation and calibration labor: $4,000–$7,500.
  • Electrical and conduit: power to the indicator, scale house and any kiosks, plus surge protection.

All figures from published industry guides (2022). Our truck scale installation team can walk your site and price these items before you commit.

California-Specific Costs Most Guides Miss

These are small next to the scale itself, but they come every year and catch new owners by surprise.

California costAmountWho charges it
County device registration, scale 10,000 lb or moreUp to $250 per scale per yearCounty sealer, B&P Code §12240
County business location feeUp to $120 per location per yearCounty sealer, B&P Code §12240
Weighmaster license (if you sell by weight)$75 per fixed location; $30 each additional; $20 per deputyCDFA, B&P Code §12704
Inspection before commercial useScale must be approved, tested and sealedCounty sealer / CDFA DMS

Sources: B&P Code §12240 and the CDFA weighmaster law extract. County fees vary up to these maximums.

Two other California factors can move the price: site engineering for soils and seismic requirements, and prevailing-wage rules if a public agency is paying for the project.

The Costs After Day One

A truck scale is a long-term asset, and what you spend keeping it accurate adds up.

  • Maintenance and calibration: Published industry figures put annual truck scale maintenance at $1,000 to $10,000, depending on the services you choose.
  • Service labor: bench time quoted at $125 to $200 per hour, plus zone-based travel.
  • Repairs: load cells, junction boxes and cables after lightning, flooding or rodent damage.
  • Downtime: the cost you don’t see on an invoice. Every hour your scale is down, trucks wait or leave unweighed.

A preventive maintenance plan and scheduled truck scale calibration keep those costs predictable. When a scale gets older, a scale overhaul can be cheaper than replacement.

Ten-year truck scale cost of ownership from about $105,000 to $229,000 including installation, maintenance and county fees
Illustrative 10-year cost built from published ranges.

What a Truck Scale Costs Over 10 Years

Here’s what the published ranges add up to over ten years for a new turnkey scale. It’s an illustration built only from the sourced figures above, not a quote.

Cost over 10 yearsLow endHigh end
Turnkey purchase and installation$95,000$125,000
Maintenance and calibration ($1,000–$10,000 a year)$10,000$100,000
County registration (up to $370 a year)Varies by county$3,700
Approximate 10-year totalAbout $105,000About $229,000

The spread shows why the cheapest scale isn’t always the cheapest choice. A well-built scale on a good foundation, maintained on schedule, usually sits toward the low end of the upkeep range.

Lower-Cost Options

Not every operation needs a new permanent scale.

  • Reuse your foundation. If the foundation is sound, replacing only the weighbridge avoids the biggest site cost.
  • Axle scales. If your main job is checking axle weights before trucks leave, axle scales cost far less. Industry guides list portable axle scales at $1,500 to $5,000.
  • Rent. For harvest, a construction job or while a permanent scale is being installed, a portable truck scale rental avoids the capital cost. Our guide on whether to rent or buy compares the two.
  • Used scales. They can save money, but check the weighbridge for fatigue and corrosion, confirm the NTEP certificate, and budget for new load cells and recertification.

Quick Cost Estimator: Which Range Fits Your Project?

Find the row that matches your project to see which published range applies and what will move your price.

Your projectPublished range to start fromWhat moves your price most
New site, new scale and foundation$95,000–$125,000 (turnkey)Foundation type, soil, length, deck type, steel prices
Replace scale on a sound existing foundationAround $80,000Scale length and model, crane access, removal of old deck
Scale equipment only (you handle site work)$45,000–$80,000Capacity, deck, load cells, freight distance
Axle weighing only$1,500–$5,000 (portable axle scales) and upPermanent vs portable, legal-for-trade needs
Seasonal or short-term needRentalLength of rental, delivery distance
Add automation to an existing scaleVaries widelyNumber of lanes, ID method, software integration

All ranges from published industry guides (2022–2023), before 2025–2026 steel price increases.

How to Get an Accurate California Quote

The fastest way to a firm number is to give your installer the right details on the first call.

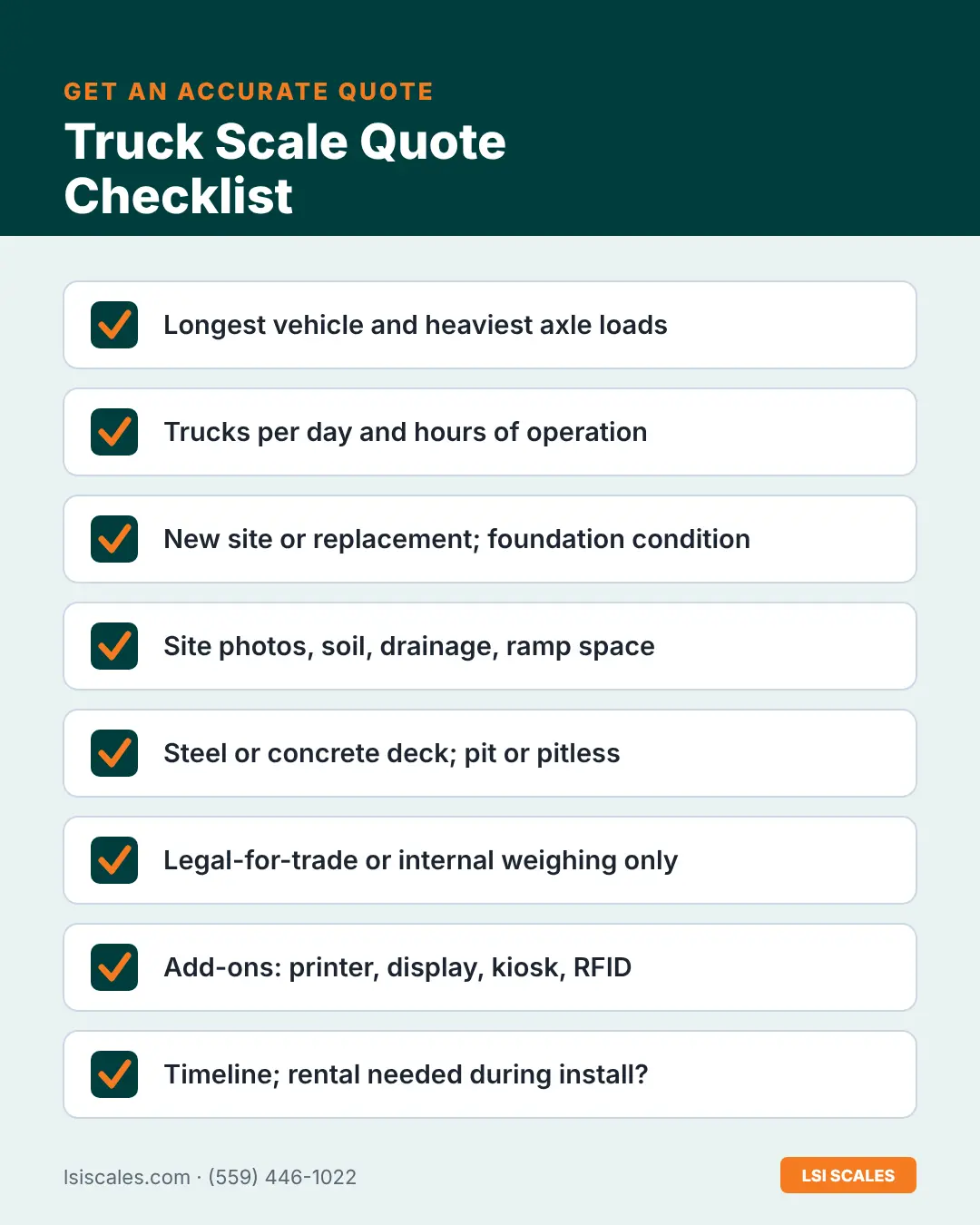

Truck scale quote checklist for California buyers covering vehicle length, traffic, foundation, deck type and add-ons
Have these details ready for an accurate quote.
  • ✅ Longest vehicle you need to weigh, and heaviest axle loads
  • ✅ Trucks per day and hours of operation
  • ✅ New site or replacement; age and condition of any existing foundation
  • ✅ Site photos, soil or drainage issues, and space for ramps
  • ✅ Preference for steel or concrete deck, pit or pitless
  • ✅ Legal-for-trade use (selling by weight) or internal weighing only
  • ✅ Add-ons: printer, remote display, kiosk, RFID, cameras
  • ✅ Your timeline, and whether you need a rental scale during installation

Ask every bidder to itemize the scale, foundation, freight, crane, installation, calibration and certification. Itemized quotes are the only way to compare like with like.

Frequently Asked Questions

How much does a truck scale cost in 2026?

Published guides put a new truck scale at about $50,000 to $100,000 and a turnkey project with foundation at about $95,000 to $125,000. These figures date from 2022–2023, and steel prices have risen since, so 2026 quotes are likely higher.

What is the most expensive part of a truck scale project?

On a new site, the scale and the concrete foundation. Industry guides estimate a typical above-ground foundation with ramps at about $30,000.

How much does it cost to replace a truck scale on an existing foundation?

Industry guides have estimated about $80,000 when no concrete work is needed.

Why are truck scale prices higher in 2026?

Steel. U.S. hot-rolled steel prices were about 70% higher in June 2026 than in February 2025, after Section 232 steel tariffs were extended to all countries and set at 50%.

What does truck scale maintenance cost per year?

Industry guides estimate $1,000 to $10,000 a year, depending on the service plan, with bench time at $125 to $200 per hour.

What fees do California truck scale owners pay?

Counties can charge up to $250 per scale of 10,000 lb or more and up to $120 per business location each year. If you sell by weight, a weighmaster license costs $75 per fixed location.

Is it cheaper to rent a truck scale?

For seasonal or short-term work, yes. Renting avoids the purchase and foundation costs. For daily, year-round weighing, owning usually costs less over time.

Steel deck or concrete deck: which costs less?

Steel decks usually cost less upfront and install faster. Concrete decks add on-site work but give a heavy, durable surface for high-traffic sites.

Get a California Truck Scale Quote

Published ranges get you in the ballpark. A site visit gets you a real number. LSI Scales quotes truck scales for sale and installation across California and Arizona, with itemized pricing for the scale, foundation, installation, calibration and certification, plus rental options while you wait.

Sources

  1. Published U.S. truck scale price and service cost guides, 2022–2023
  2. Rice Lake Weighing Systems, What impacts the price of a truck scale?
  3. Cato Institute, Steel prices rise again amid persistent US tariffs, July 2026
  4. California Business and Professions Code §12240
  5. CDFA, Weighmaster law extract, §§12700–12737
